WorkAI Network Optimizer

AI Network Optimizer (0→1) | Unilever

Designing an AI logistics planning tool that planners could trust, even when the AI couldn't explain itself.

Network Optimizer is an AI planning tool for Unilever India's transportation planners. It replaces the spreadsheet process for costing inbound shipping routes.

  • Enterprise
  • AI
  • Logistics
  • FMCG
  • 0→1
Cover The Network Optimizer map view on a tablet, above an illustrated supply chain of plants, trucks and wind turbines
Tools
  • Figma
  • FigJam
  • Excel
  • Word
  • Role

    Lead Product Designer

    Sole designer

  • Timeline

    Jul – Sep 2024 (design)

    Launched Month Year

  • Team

    1 Product Owner, 4 Developers, 2 Data Scientists and me

  • Skills

    User experience, user interface, concepts, prototyping, interaction design

Outcome & impact

  • Measured40–50%Shorter planning cycle (7 → 4 days)
  • Measured60%Less rework
  • Projected8–10%Cost savings identified

TLDR

Got a minute?

Planners already knew the routes. They couldn't prove which one was cheapest. I designed a 0→1 tool that shows them the cheapest option and leaves the final call with them.

With it, planners consistently uncover cost-saving opportunities, refine route decisions with confidence, and produce execution-ready shipping plans with far less manual effort.

Problem

Planners built inbound shipping plans in spreadsheets every month and quarter. Each cycle took days of data gathering and validation. It still couldn't tell them whether a cheaper route existed.

My role

I led UX for this 0→1 MVP as the only designer, from early alignment to developer-ready designs. I worked with Product, Engineering and Data Science to turn optimization logic into a workflow planners could trust, within real limits on model explainability and data readiness.

Context

What was it about?

What it is
An AI planning tool for Unilever India’s transportation planners, in place of their costing spreadsheets.
What planners get
An automated baseline, a map of the network, and scenarios to compare before locking the month’s plan.
Why it matters
Once the month’s network is set, every extra kilometer repeats as cost across routes, regions and volumes.
The Network Optimizer welcome screen, Supply Chain Network Optimizer, on a desktop monitor

The opportunityFind more efficient routes and show the true cost of every shipping decision, without heavy manual planning.

Why · the problem

Every month, planners rebuilt the same plan from scratch

The network it covers

Processing plants
15+
Depots
25+
Suppliers & packaging units
80+
Lanes
300+
Annual inbound logistics spend
~₹150 cr

Issue 01

High manual effort

Every cycle started with gathering data by hand from fragmented sources: plant-to-plant dependencies, packaging flows, lane data.

Issue 02

No memory between cycles

The same workflow ran monthly for execution and quarterly for forecasting. Nothing carried over, so nothing got faster.

Issue 03

No way to see a better route

Formula-driven costing was error-prone and hard to audit. The plan got finished, but it never showed whether a cheaper route existed.

A cycle before the tool: the plan, and everything it depended on.

Users

Planners knew the network. They couldn't prove the best route.

They plan the inbound network for Unilever India's supply chain. Their plans go to a logistics manager, who reviews and approves each one and needs confidence in the AI output.

Users

Transportation and logistics plannersUnilever India · Supply chain operations

  • Monthly planning
  • Cost forecasting
  • Operational feasibility
Geography
IndiaPrimarily India-based teams managing the national supply network
Planning cycle
Monthly and quarterlyExecution plans every month, forecasts and pre-plans before each quarter
Network scope
End-to-end routingPlants, depots, suppliers, packaging units and inbound legs

Every decision sits between three pressures

  • Cost controlEvery routing decision carries a cost that repeats across routes, regions and volumes.
  • Planning speedPlans must be ready before each month or quarter. Delays cascade into operations.
  • Delivery reliabilityRoutes must work in practice, not just be cheapest on paper.

Proto-persona

Arjun Mehta, the proto-persona

Arjun Mehta

Senior Transportation Planner · Unilever India

  • Age 34
  • Mumbai, India
  • 8 yrs experience
  • Supply chain / Logistics

Persona typeThe Meticulous Planner

Built from recurring planner feedback, not interviews.

I already know the network. I just need a faster way to prove which route is actually the best, and to show the numbers to my manager.

Arjun has managed inbound logistics across Unilever India for close to a decade. He builds monthly shipment plans and quarterly forecasts by routing flows between plants, packaging units, depots and suppliers. He knows the network deeply, but most of his time goes into calculations he knows could be automated.

His goals

  • Finalize monthly plans quickly, without spending days on spreadsheet calculations.
  • Identify the most cost-efficient route scenario with confidence.
  • Reduce rework caused by errors found only after plans are submitted.
  • Reuse past plans as a starting point rather than rebuilding from scratch.

His pain points

  • Data is scattered across emails, SAP exports and stakeholder inputs. Collecting it takes hours before planning starts.
  • Spreadsheet costing only validates. It never shows whether a better route exists.
  • Errors surface after export, which forces last-minute rework under deadline pressure.

What he needs most, ranked

  1. Cost visibility
  2. Speed of output
  3. Scenario comparison
  4. Editable scenarios
  5. Network map view ranked last. See decision 01

Tools he uses today

  • Microsoft Excel
  • Email
  • SAP
  • WhatsApp (coordination)
  • Manual data validation

Core tensionCost control, planning speed and delivery reliability. Arjun balances all three every cycle, with no tool that shows him the trade-offs clearly.

Research

No formal study. The evidence came from four live planning cycles.

This MVP had no dedicated research phase. The planning cycles themselves were the research: the same friction came up every month and every quarter.

  • Source 01

    Recurring planner pain points

    The same friction surfaced in every monthly and quarterly cycle, which gave a clear signal on what mattered most.

    3 monthly cycles and 1 quarterly cycle

    What it told usWhich steps were most effort-heavy and error-prone.

  • Source 02

    Stakeholder workshops

    Cross-functional alignment sessions with stakeholders across the supply chain.

    3 sessions with planners, the logistics manager, the product owner and data science

    What it told usWhere planning broke down across the supply chain.

  • Source 03

    Operational reviews

    6 spreadsheet audits of past monthly plans

    What it told usMost errors started in manual lookups between tabs, and validation alone added 2–3 days to every cycle.

This gave us clear direction on scope quickly, without waiting for formal research. The recurring nature of the pain points meant the signal was already rich and validated by operational reality.

Before

Planners spent more time verifying than optimizing

  1. Normal01

    Collect network inputs

    Gather data from plants, depots, suppliers and lanes.

    PainData scattered across emails and SAP exports, in inconsistent formats.

  2. Normal02

    Build route plans by hand

    Map lanes: processing → packaging → depots.

    PainNetwork complexity makes this slow and repetitive every month.

  3. High friction03

    Calculate costs in spreadsheets

    Compute inbound costs with formula-driven sheets.

    PainError-prone and hard to audit. Errors stay hidden until downstream.

  4. High friction04

    Validate repeatedly

    Cross-check outputs against source data several times.

    PainMore time verifying than optimizing.

  5. Normal05

    Finalize the monthly plan

    Lock the execution plan and the quarterly pre-plan.

    PainNext month starts from scratch, with no reuse and no learning.

longer turnaround
35–45%
of validation loops before a plan was ready (step 04)
2–3 days
route optimization: alternative routes were never costed
0%
restarts from scratch
↻ Monthly

Steps 03 and 04 were the bottleneck. Planners spent more time checking numbers than improving them.

Core insight

The problem wasn't routing. It was proof.

Planners didn't need help finding routes. They already knew them. The question they had to answer every month was:

“Are we shipping in the most cost-efficient way possible, given our real network constraints?”

They needed to answer it with confidence, and show the numbers to their managers.

Constraints

Explainability and lane‑level costs had to wait

To ship a reliable 0→1 MVP on time, we focused on the core optimization workflow. Two capabilities needed more mature models and data, so we deferred them.

Guiding principle, from the stakeholder workshopDeliver core value first, defer complexity. Ship fast, learn, then expand.

Deferred 01

AI explainability

Intent
Show planners why the AI chose a route.
Constraint
The optimization layer didn't consistently expose decision-level reasoning in a structured, trustworthy way.
The decision
Planned for a later release, once explainability data is stable.

Deferred 02

Lane-level cost breakdown

Intent
Show route-level and leg-level cost drivers.
Constraint
Needed consistent lane mapping, a mature data model and performance tuning for large datasets.
The decision
Deferred to keep the MVP simple.

Deferring explainability created the central design problem

How do you get planners to trust a recommendation the AI can't explain?

Designing for trust

If the AI can't explain itself, let planners check its work

The goal was not

To replace planners or automate their decisions away.

The goal was

To cut the time spent on repetitive calculation and validation, and give it back to making the best decision.

I designed three ways for planners to check the AI against what they already knew.

AI proposesThe best-cost plan
  1. Check 01 · baseline

    Anchor it to their own numbers

    The AI's best cost always sits next to the planner's baseline.

  2. Check 02 · map

    Show it on the network they know

    On a map, an odd or unrealistic route stands out in seconds.

  3. Check 03 · edit

    Let them change it

    Any value can be edited, and the cost updates instantly.

Planner decidesLocks the plan

Three design pillars

  • Pillar 01 · Speed

    Less time calculating and validating

  • Pillar 02 · Optimization

    Reveal the best-cost scenario

  • Pillar 03 · Control

    Keep planners' judgment in the plan

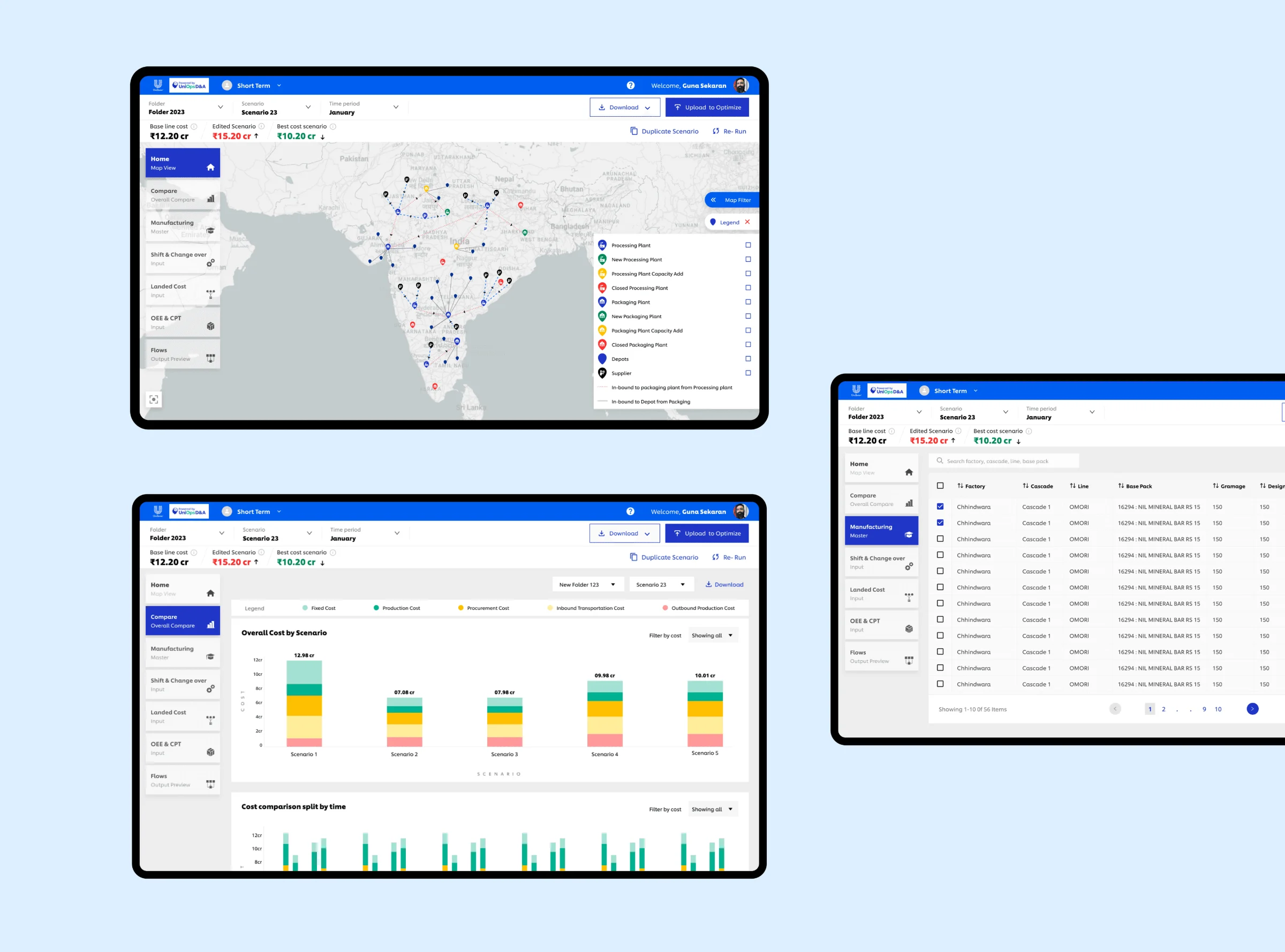

Three Network Optimizer screens on tablets: the map view, the scenario comparison, and the editable scenario data

Key decisions

Three calls that shaped the product

The stakeholder workshop produced a long list of ideas. These three decisions shaped the product most, and each one had an alternative we chose against.

Decision 01

The tensionPlanners ranked the map last among their needs. Cost visibility came first.

Alternative

A cost table or dashboard as the home screen (confirm)

Chosen

The map is the working canvas. The three-scenario cost strip is pinned in the header on every screen.

Why?Cost never leaves the screen, so the top need is always met. The map adds what a table can't: a fast way to sanity-check AI routes against a network planners know by heart.

From pain to decision

Every planner pain from the old cycle, the decision that answers it, and where it lives in the product. It condenses the stakeholder workshop board.

Planner painDesign decisionWhere it lives
Days spent collecting and costing dataUpload baseline data, get costs instantlyUpload and instant cost
No way to know if a cheaper route existsAI best-cost scenario shown against the baselineThree-scenario view
Network invisible inside spreadsheetsPlants, depots and routes on a mapMap view
Hard to explain the "why" behind numbersDrill down to any depot or plantLocation drill-down
Errors found only after exportEdit in the tool, recalculate instantlyEdit and refresh
No way to weigh optionsScenarios side by sideScenario comparison

Network Optimizer · Stakeholder workshop board (FigJam)

The stakeholder workshop board in FigJam, in five sections: problem framing, who we're designing for, what the product should do, what we're not building (deferred), and the key design decisions

Solution

One planning cycle, start to finish, in one tool

Six features, in the order a planner moves through a cycle. Each one is tagged with the pillar it serves, so the thread runs on to the outcomes.

The upload dialog: baseline data uploaded and the best-cost scenario created, with a base line cost of ₹12.20 cr and a best cost of ₹10.20 cr
Upload scenario data → instant baseline and best cost

01Upload

Speed

Upload data. See costs instantly. No spreadsheets.

Planners upload baseline datasets and see the overall inbound shipping cost right away. Manual spreadsheet costing is gone.

Impact → Less time on repetitive cost calculations. Planners move from collecting data to making decisions faster.

The map view: plants, depots and routes plotted across India, under the three-scenario cost header
Network map: depots, plants and routes visible

02Map view

Control

The network, finally visible, not just calculated.

A map plots shipping plans across India, with plants, depots and routes as real network points and clear cost differences between them.

Impact → High-cost lanes are easier to spot, and route patterns are easier to trust.

The three-scenario cost header, base line, edited and best cost, above the map
Baseline · Edited · Best cost, three scenarios in one view

03Three-scenario view

Optimization

Three scenarios. One view. Cost optimization made visible.

Baseline, Edited and Best cost sit together in the header on every screen: the uploaded cost, the cost after manual edits, and the AI-optimized cost.

Baseline

₹12.20 crUploaded plan

Edited

₹11.60 cr↓ 4.9% vs baseline

Best cost

₹11.10 cr↓ 9.0% vs baseline
The header strip, pinned on every screen (demo numbers)

Impact → Faster comparison, more confidence in the AI output, fewer manual recalculations.

A packaging plant opened from the map, with its location-level data in a table beside the map
Drill down to depot and plant level detail

04Location drill-down

Control

Every depot. Every plant. Drill down to check at the source.

Planners can open any depot or plant (processing, new or closed, packaging) and check the details behind the numbers.

Impact → Less manual cross-checking, and faster answers when planners need to explain the "why".

The scenario data table, with one row being edited to generate a new best cost
Edit scenario data → updated cost output instantly

05Edit and refresh

Control

Edit the scenario. Refresh the cost. No rebuild.

Planners edit baseline data directly in the tool and get an updated Edited-scenario cost instantly.

Impact → Planners can test real-world adjustments without rebuilding the plan from scratch.

The Compare view: overall cost by scenario as stacked bars, side by side
Overall cost by scenario, compared side by side

06Scenario comparison

Optimization

Put scenarios side by side. See what changed.

A Compare view shows the total cost of several scenarios side by side, broken down by cost type.

Impact → Planners choose between outcomes backed by evidence, not just between routes.

Outcomes

Faster cycles, less rework, and a savings gap planners could finally see

Each outcome maps to one design pillar, and says whether it was measured or projected.

  • SpeedMeasured

    40–50%Shorter planning cycle (7 → 4 days)

    Instant cost generation on upload replaced the manual spreadsheet loop that used to take days.

    MethodHow it was measured, and over how many cycles

  • OptimizationProjected

    8–10%Potential cost savings identified

    The AI best-cost scenario surfaced savings planners couldn't see before, and made the gap between the current plan and the optimal one visible for the first time.

    MethodGap between the baseline and the best-cost scenario across X cycles, before planner edits. Realized savings, if known

  • ControlMeasured

    60%Less rework

    Map visibility and editable scenarios let planners check and adjust before committing, which cut the post-submission corrections that used to restart the cycle.

    MethodPost-submission corrections per cycle, before and after. How they were counted, and over how many cycles

A quote from a planner, the product owner or a supply chain lead about the tool's impact

Name or role

What happened next

Launch
Month Year, used by X planners across X planning cycles
AI explainability
Shipped, in progress or still deferred
Lane-level cost breakdown
Shipped, in progress or still deferred
Beyond the MVP
Any expansion: other regions, longer-term forecasting, new users

Reflections

What I'd keep, and what I'd change

What I'd keep

0→1 MVPs demand ruthless prioritization

I learned to prove the core value early instead of trying to solve every edge case in the first release. Choosing what to defer, and designing around that gap, shaped this product as much as any screen did.

Speed and alignment matter more than perfection

Quick stakeholder alignment and clear milestones moved the project forward in a complex enterprise setup.

What I'd change

I'd measure the baseline before launch

Some outcomes here are estimates because the old cycle time wasn't tracked systematically. Next time I'd record the "before" state in week one.

I'd push for a minimal cost-driver view in the MVP

Comparison, the map and editing gave planners enough to check the AI, but not to see why it chose a route. Even the top three cost drivers per route would have answered most of those questions without full explainability.

Final thoughts

This project made me confident designing 0→1 enterprise products where complexity is high, timelines are tight and the AI can't do everything yet. The work was less about screens and more about shaping a workflow, aligning Product, Engineering and Data Science, and turning an optimization model into something planners would actually use.

Open for opportunities

Building something complex? Let's make it clear.

I partner with teams to turn complex problems into clear, human-centred solutions.
